Our Competitive Advantage.
|
Option#1
New Line |
Option#2
Re-Conductor |
Option#3
Bundled-line |
Option#4
Add Tower |
Option #5
Raise Towers |
Option #6
Install SLiM |
Cost |
Very High |
Very High |
Very High |
High |
Moderate to High |
Low to Moderate |
Probability of higher cost |
Medium |
High |
High |
High |
High |
None |
Environmental impact |
High |
Low |
Low |
High |
Low |
None |
Visual impact |
High |
None |
Low |
High |
High |
Low |
Live-line work |
Maybe |
No |
No |
No |
Maybe |
Yes |
Applies to all profiles and configurations |
Yes |
Maybe |
Maybe |
Maybe |
No |
Yes |
Failure risk during installation |
Low |
Low |
Low |
Medium |
High |
Low |
Reliability of option |
High |
High |
High |
Medium |
Low |
High |
Case Study:
- Sag, Conductor temp, and current on typical line configurations with and without SLiM with various Range of Motions (ROM)
- Fixed conditions:
- Span with anchor (dead-end) towers at same elevation
- Wind speed of 2 ft/sec perpendicular to line & high solar
- Reference temp (Tref) of 40degF (4.3degC) for line tension and relative sag calculations
- Assumed that the current in line is limited by sag that SLiM can remove from line

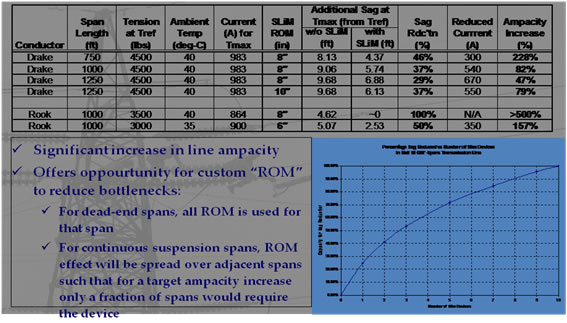

Results:

|
